Magna-loc, Eave offset over decking – Metal Sales Magna-Loc Installation User Manual
Page 69

© Metal Sales Manufacturing Corporation / Subject to change without notice 6/12
69
MAGNA-LOC

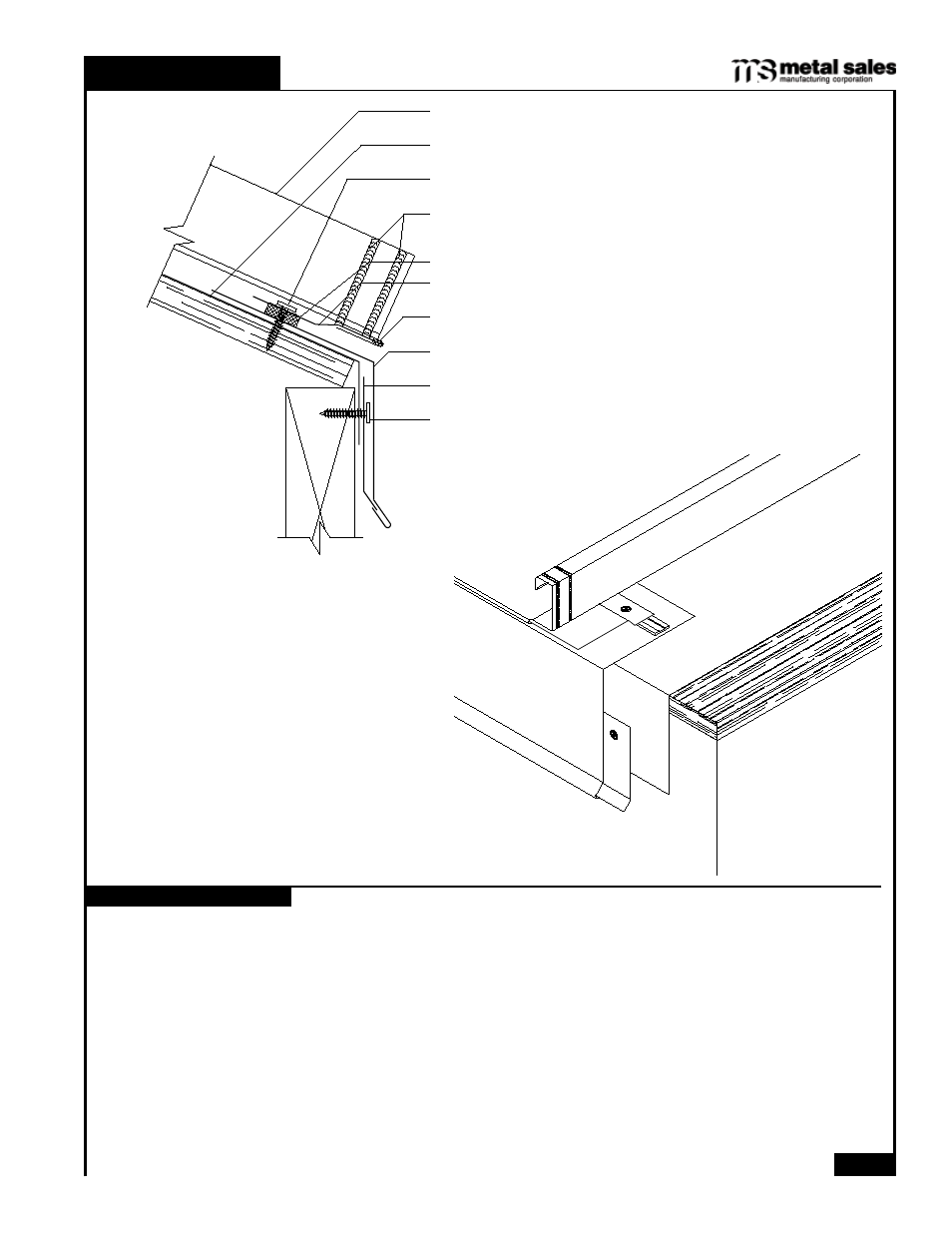

eAVe OFFset OVer deCKING
Double Bead Tape Sealant
#10-12 x 1" PHW (1'-0" o.c.)
Magna-Loc Panel
Moisture Barrier (by others)
Offset Cleat
Eave
Tube Sealant (between panel ribs)
Cleat
Tube Sealant
#10-12 x 1" PHW (1'-0" o.c.)
INstALLAtION NOtes
All Eave flashings must be installed prior to panel installation.
1. Position and install Cleat to wall with appropriate fastener, 12"o.c. Make sure Cleat allows for proper Eave attachment.
2. Install Eave flashing by sliding open hem onto Cleat and resting the Eave flashing back against substrate. To hold Eave
flashing in place fasten to substrate with #10-12 x 1" Pancake Head fastener, 4'-0"o.c.
3. Apply a row of Double Bead Tape Sealant across Eave flashing approximately 2"-3" from face of Eave flashing.
4. Properly align and install Offset Cleat so that Magna-Loc panel will be flush with Eave flashing. Fasten through Offset
Cleat, Tape Sealant, Eave Flashing and into substrate with Pancake Head fastener at 1'-0"o.c.
5. Apply a continuous bead of Tube Sealant along outer edge of Offset Cleat in panel hem.
6. If two or more flashings are required, lap the flashing over the previously installed flashing by a minimum of 2" placing a
bead of Tube Sealant between the flashings and securing with Pop Rivets, 2.5"o.c.
7. Install Magna-Loc panel by engaging field hemmed panel end (see page 82) over Offset Cleat. Two beads of Tube
Sealant must be applied up and over male leg of each Magna-Loc panel during panel installation (see page 49).
1
/
2
:12 slope
Minimum
